Installation planning and site readiness

Our installation and training process connects the accepted machine configuration with the conditions on your production floor. Before shipment, the project plan identifies positioning, utilities, product supply, package handling and downstream interfaces. It also defines the commissioning sequence and the operator tasks to practice during startup.

Commissioning support is arranged as remote guidance or an agreed site visit according to the equipment, destination and project scope. The handover plan records responsibilities, timing, language and the documents needed at the machine. This lets your site team prepare connections, materials and operators before startup.

Site readiness checklist

Many startup delays trace back to the site rather than the machine. Walk through this checklist against the final layout drawing before delivery.

  • Floor space for operator access, guard-door swing, film-roll or component loading, and the route used to bring the machine in
  • Electrical supply matching the voltage, phase and frequency on the final drawing, with the isolation point settled ahead of time
  • Compressed air at the stated pressure and flow, with drying and filtration suited to any air that reaches product-contact areas
  • For warm-filled products such as honey or some sauces, the heating connection and a safe routine for working near hot surfaces
  • Production material and packaging for startup checks, stored at normal production conditions
  • Named people on your side for lifting, utilities and any local electrical work

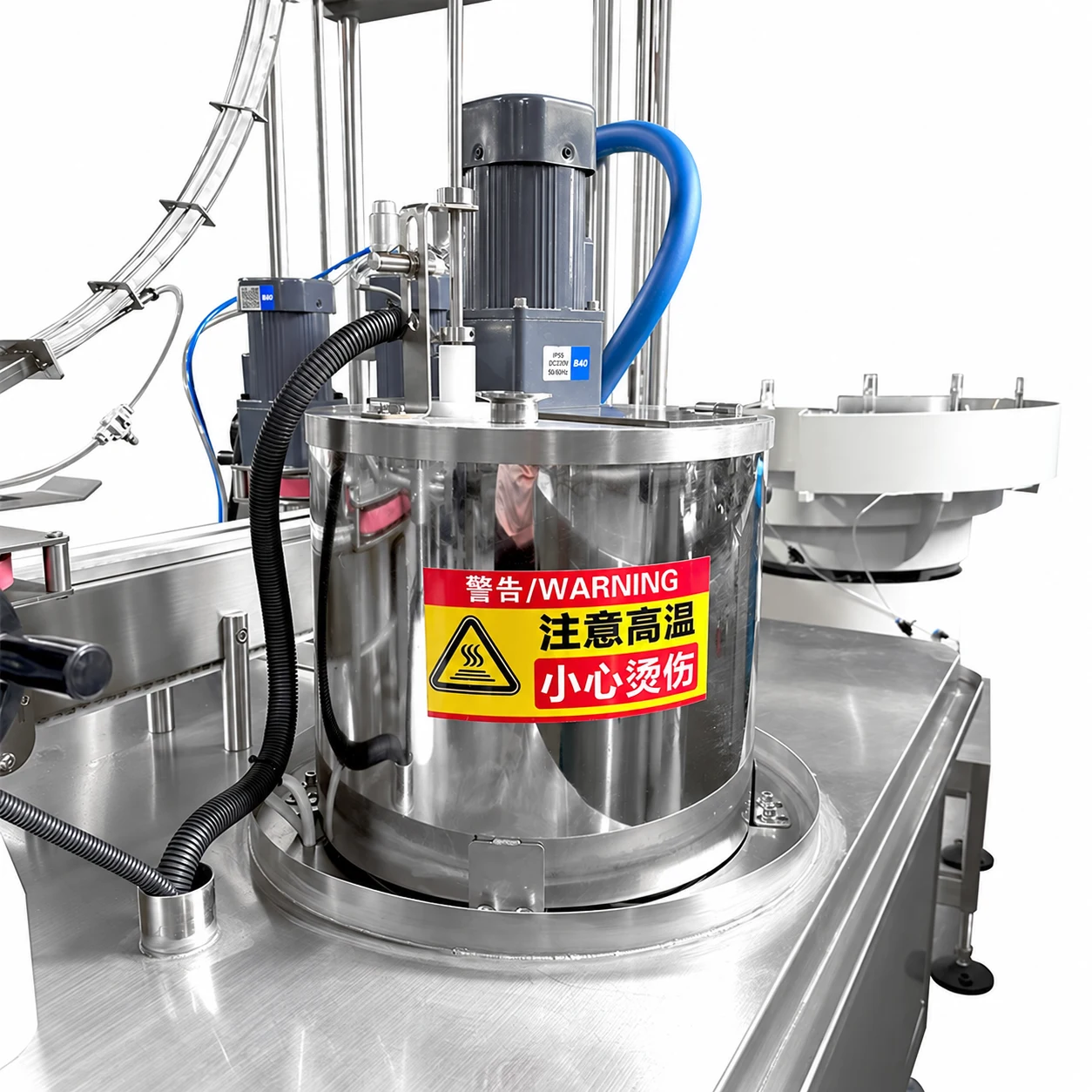

Stainless product supply tank with geared motor, hoses and a hot-surface warning label on a dosing-cap line
Heated supply tanks need the power connection sorted out and safe hot-surface handling before startup. AI-retouched product illustration.

Remote or on-site commissioning

For remote commissioning, we agree the communication method, operating contact and exchange of photos, settings and video. The site team positions and connects the equipment under the agreed responsibilities, then works through the startup sequence with the support contact. A clear view of the machine and its settings helps both teams follow the same operating condition.

For an agreed site visit, the plan identifies the site preparation, material availability and commissioning activities. The same process applies to either support method: confirm readiness, check the setup, run the selected product and package, and retain the settings and observations from startup.

Define when commissioning is complete

Commissioning means setting up, adjusting and checking the machine at your site against criteria you settled beforehand. Define completion in measurable terms, for example a stated number of consecutive acceptable packs on your own product and film, with fill weights recorded by lane and seals checked. Without that definition, the end of commissioning becomes a matter of opinion.

Record the final settings, recipe values and change parts in use, and file them with the acceptance records. Later troubleshooting is far easier against that baseline than against memory.

An operator training agenda based on a real shift

Training should follow a working shift rather than a tour of the machine. Ask for hands-on practice on each item below with the operators who will run the line. Check which topics the standard session covers, and which ones need a scheduled follow-up.

  • Startup, shutdown and emergency stop, including how to recover after a stop in mid-cycle
  • Recipe selection, and which settings operators may change versus those reserved for maintenance staff
  • Film threading and splicing or component loading, depending on the machine
  • Jam recovery in cap feeders, pouch magazines or the sealing area using the supplied stop, isolation and restart procedure
  • The cleaning sequence for product-contact parts and a check that everything is correctly reassembled
  • Shift-start checks such as seal appearance, a sample fill weight from each lane, and air pressure

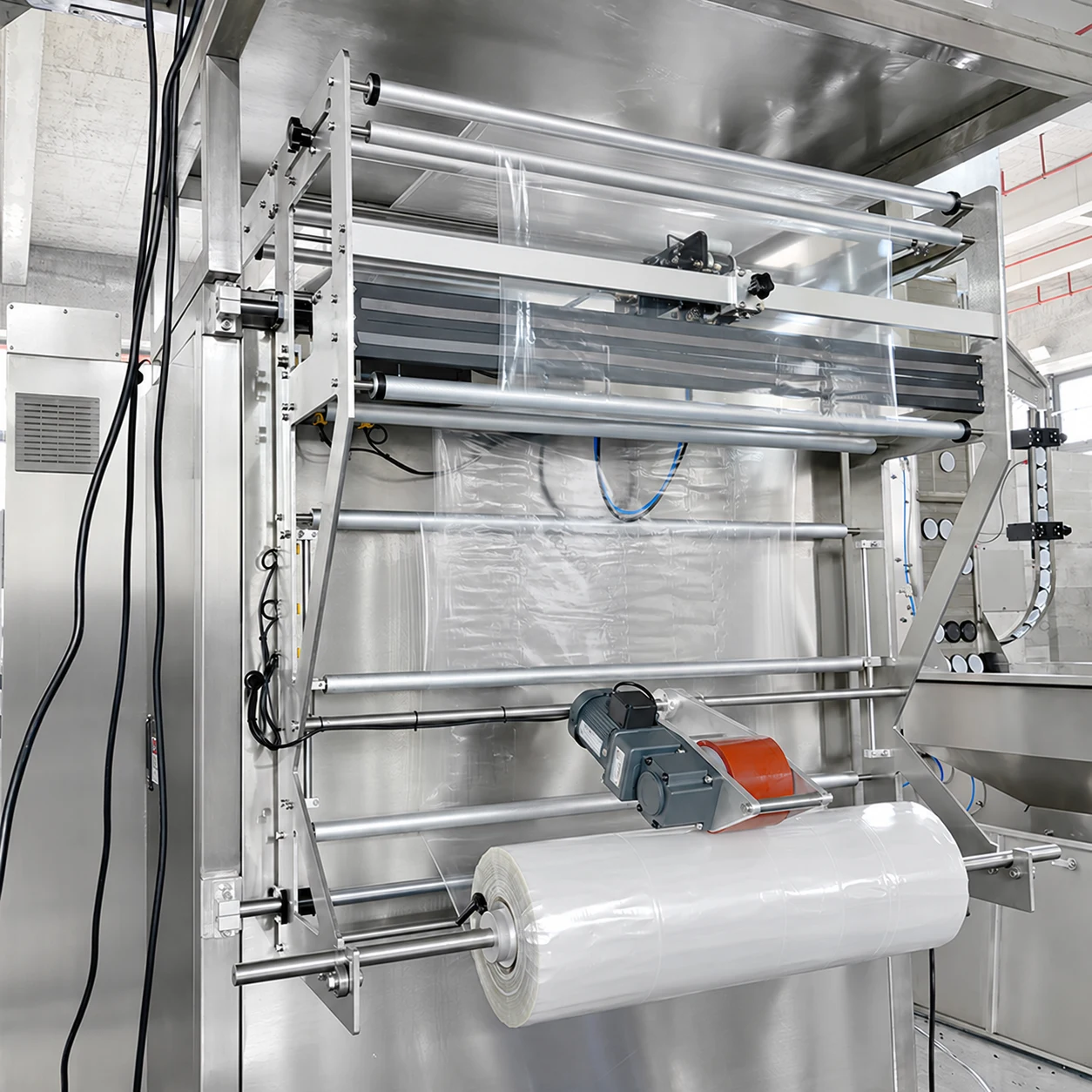

Clear packaging film threaded over tension rollers from a film roll on a vertical bagging machine
Film loading and threading is a hands-on topic operators should practice before production starts. AI-retouched product illustration.

Wear parts and later support

Settle the list of recommended wear parts before delivery, such as sealing elements, cutting knives and the gaskets in the dosing path. Decide which ones you will keep on site. Put the spare-parts arrangement in the project documents so a routine order doesn't need renegotiating later.

When you raise a support question later, include the machine identification and the settings in use. Note what changed before the problem started, and send photos or short video taken with the guards closed.

Common questions

Is on-site installation included with a filling machine order?

Installation and commissioning support follow the delivery scope. We identify remote guidance or an agreed site visit, responsibilities, timing and site preparation in the project plan.

Can a filling machine be commissioned remotely?

Often, if your site is ready for it. Remote commissioning needs a stable video connection, someone who can film while an operator makes adjustments, and a settled way to exchange settings and photos. Work out the overlapping hours and the completion criteria in advance, so both teams know when startup counts as finished.

How long does filling machine operator training take?

The training plan follows the selected machine and the operator tasks, including startup, recipe changes, routine clearing, cleaning and reassembly. Duration and any follow-up are defined with the project scope.

Which spare parts should I keep for a filling machine?

Hold the parts that wear with normal running, typically sealing elements, cutting knives and the gaskets or seals in the dosing path, plus any part whose failure would stop production for long. Ask for a recommended list with the configuration, and settle the ordering arrangement in the project documents before delivery.
